Projects / Bridges

Savana Bridge Forensic Structural Engineering

Central Africa

Savana Bridge Forensic Structural Engineering
Savana Bridge Forensic Structural Engineering, photo 2
Savana Bridge Forensic Structural Engineering, photo 3
Savana Bridge Forensic Structural Engineering, photo 4
Client
Confidential
Location
Central Africa
Dates
2023-2024
Construction cost
Confidential
Key services
  • Bridge Technical Leader
  • Bridge and Civil Structures Senior Engineer
  • Forensic Structural Investigation
Typology
  • Single-span Reinforced Concrete (RC) Span RC Bridge: 9m

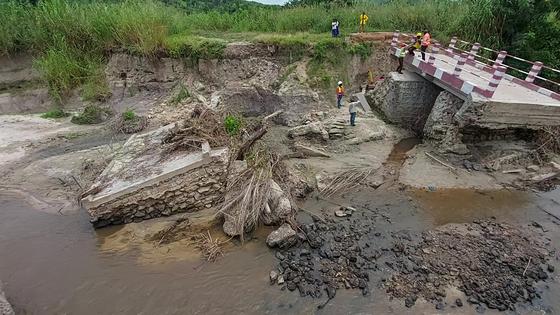

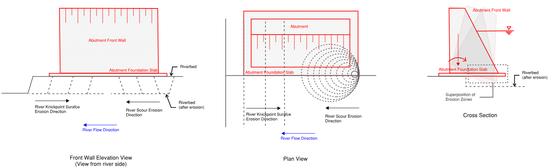

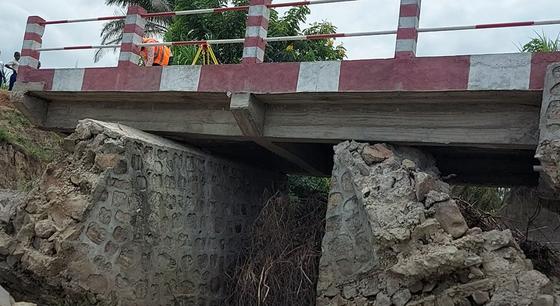

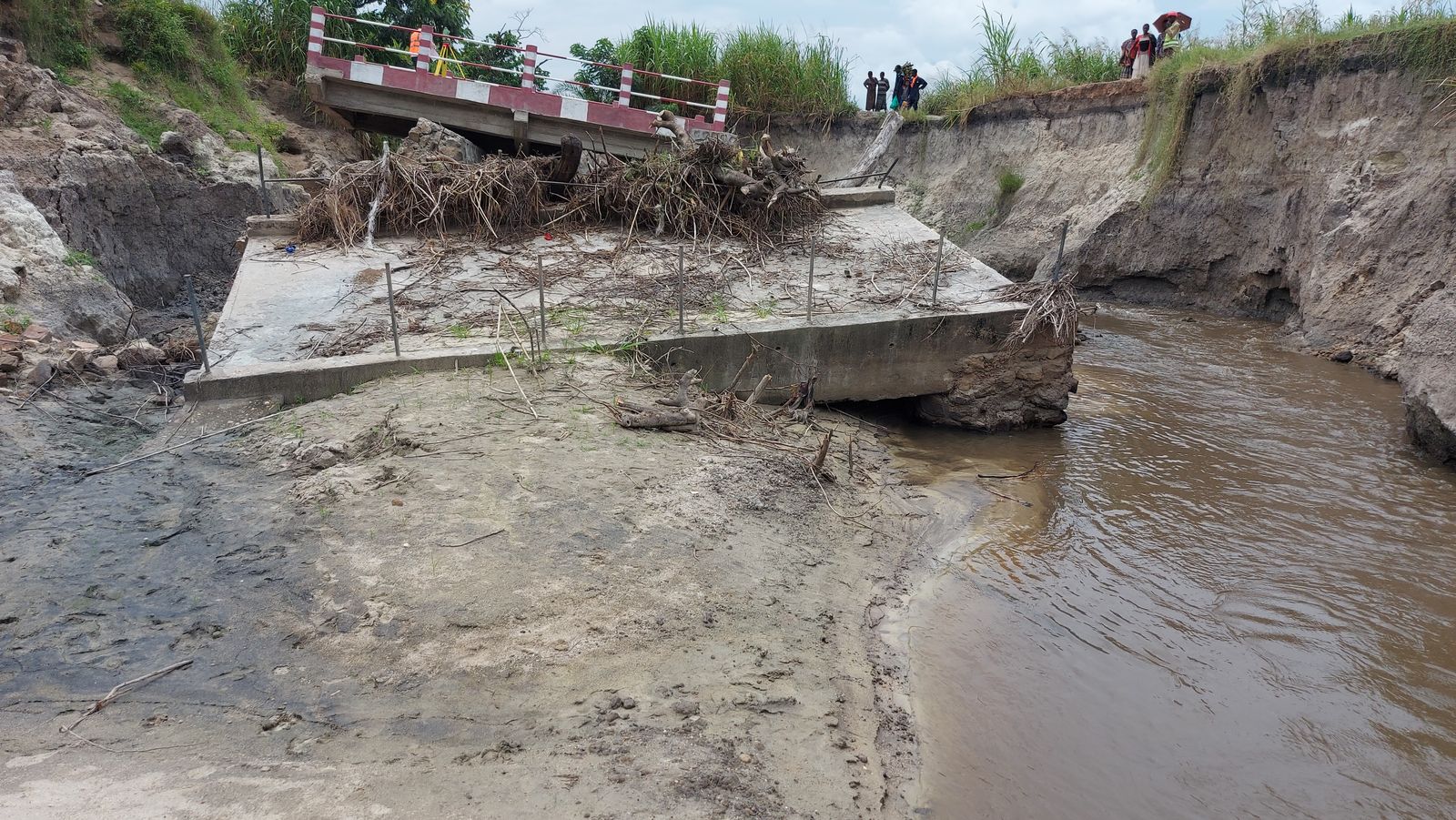

In the morning of Wednesday November 29th 2023, Client’s Representative was informed by a third party that the bridge located in Central Africa has collapsed. The day before, November 28th 2023, Client’s Representative already reported the destress of an adjacent bridge structure (Existing Bridge), located barely 12-15m downstream of the Savana Bridge. Based on the information recollected onsite on November 29th, 2023, and following the interview of a rice field worker, the collapse of the Existing Bridge would have been on November 25th, 2023.

Based on the information recollected onsite, a field trip mission and the assessment of design and construction documentation, a Forensic Structural Investigation was undertaken on the cause(s) of the bridge collapse and corresponding triggering effect. Additional efforts included visual damage mapping, photographic documentation, and interviews with local authorities and witnesses to validate the timeline and context of structural failure.
